After adding the equipment information in SCRAMNET, and reviewing the general guidelines for house arrest equipment assignment, the next step is to install the SCRAM CAM or House Arrest bracelet on the client’s ankle and assign the equipment for monitoring.

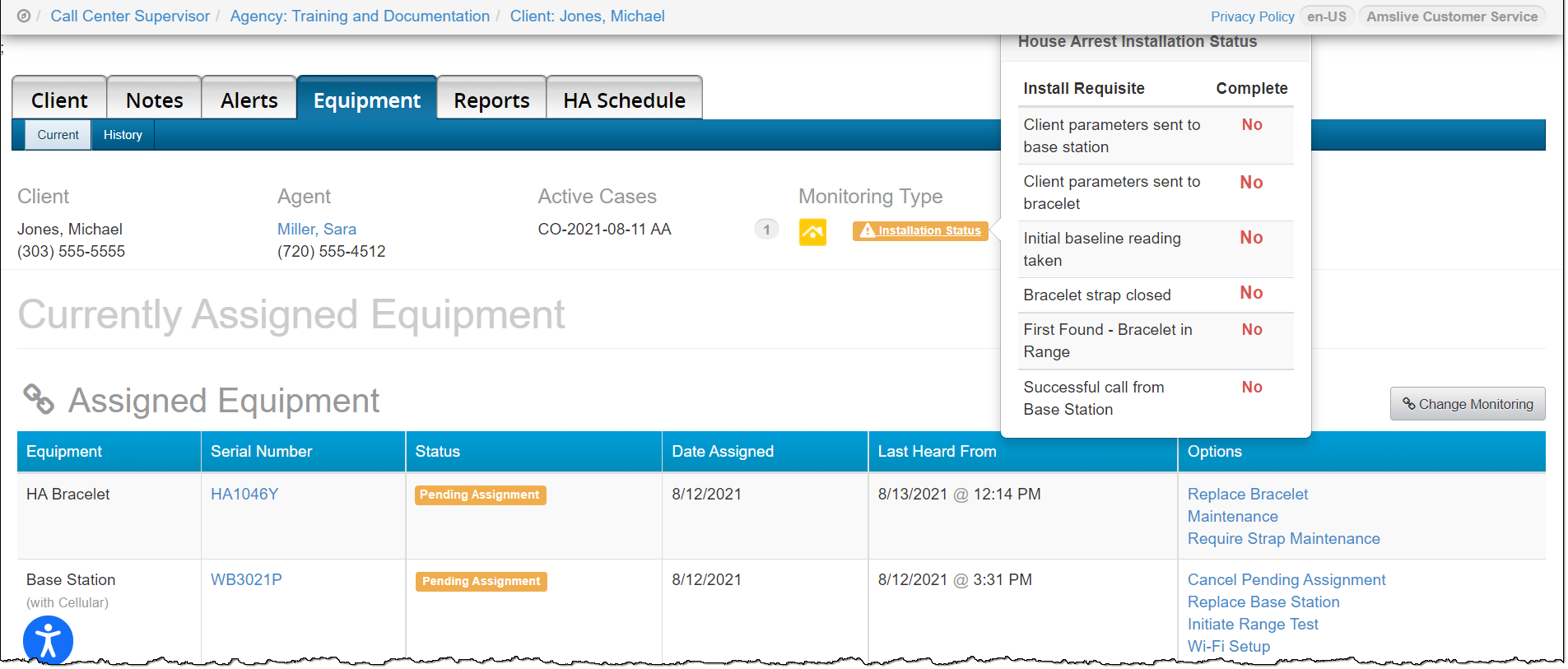

In addition to assigning the equipment to the client, there are six House Arrest installation requisites that must be met before active house arrest monitoring can begin. The requisites are:
- Client parameters sent to base station
- Client parameters sent to bracelet
- Initial baseline reading taken
- Bracelet strap closed
- First found – Bracelet in Range
- Successful call from Base Station
![]() |
|
SCRAM House Arrest Client (curfew monitoring only) click to enlarge |
![]() |
| SCRAM CAM + House Arrest Client (alcohol and curfew monitoring) click to enlarge |
This article will cover assigning the equipment and completing the six house arrest installation requisites using a base station.
- Install the bracelet components
- Install the bracelet on the client’s ankle
- Assign the bracelet and base station
- Assign the bracelet and Wireless base station
Get Started

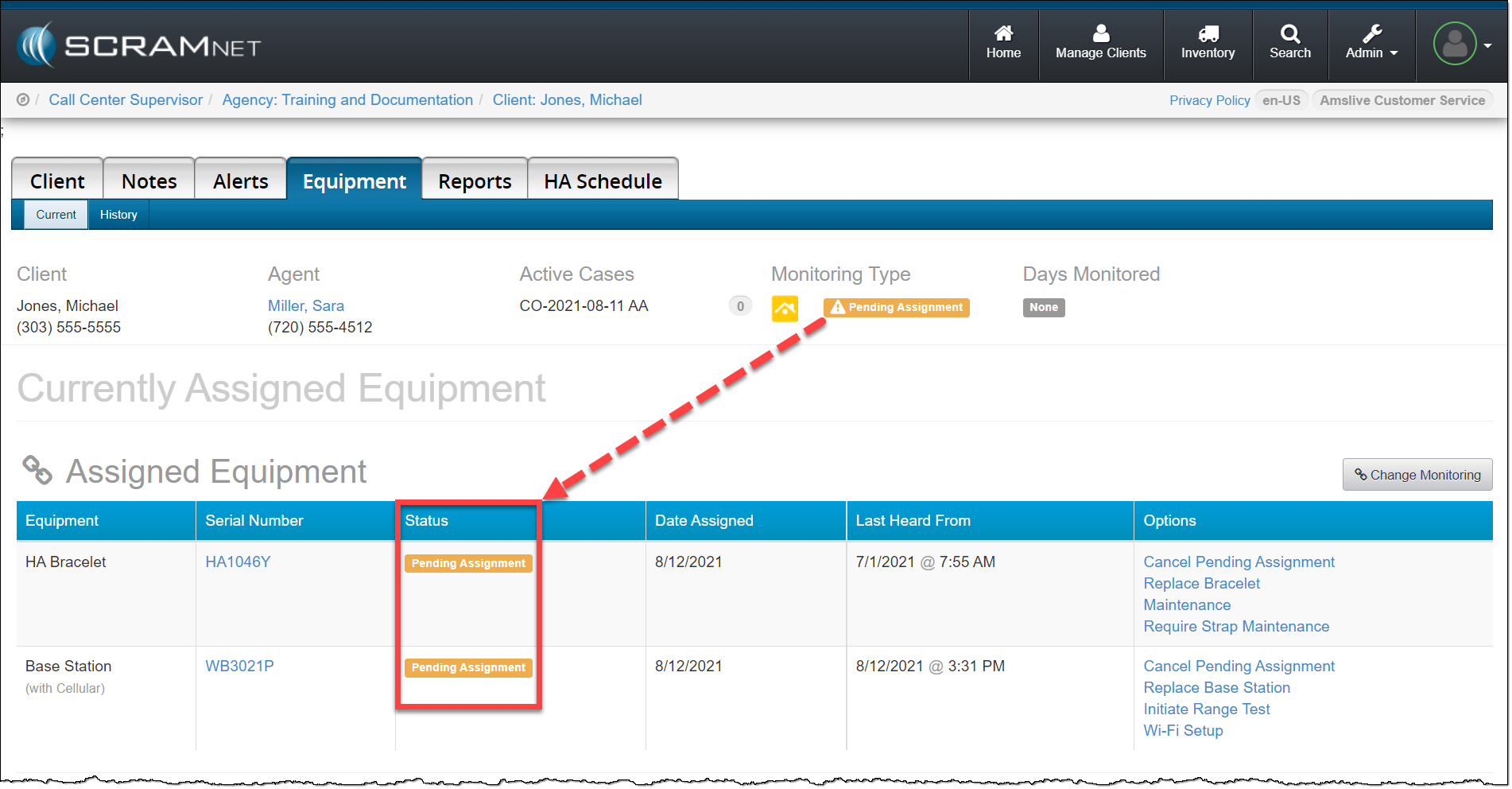

Verify the client’s equipment status is displaying Pending Assignment in SCRAMNET before beginning. If the equipment being installed and assigned to the client is not in a Pending Assignment status, add the equipment information or contact SCRAM Systems Customer Service for assistance.
Install the Bracelet’s Components
- Open the battery/faceplate kit.

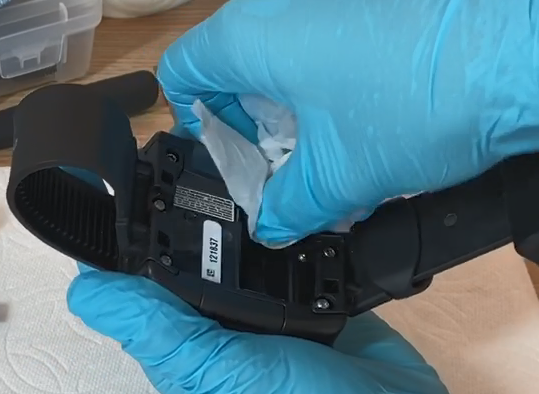

- Using the wipe provided, wipe the battery contacts, and then dry them with a paper towel or microfiber cloth.
- Install the battery into the battery compartment.
- The positive side of the battery is positioned towards the bottom of the bracelet body.
- Ensure you see a green light when the battery is installed. The green light will turn off after five seconds.

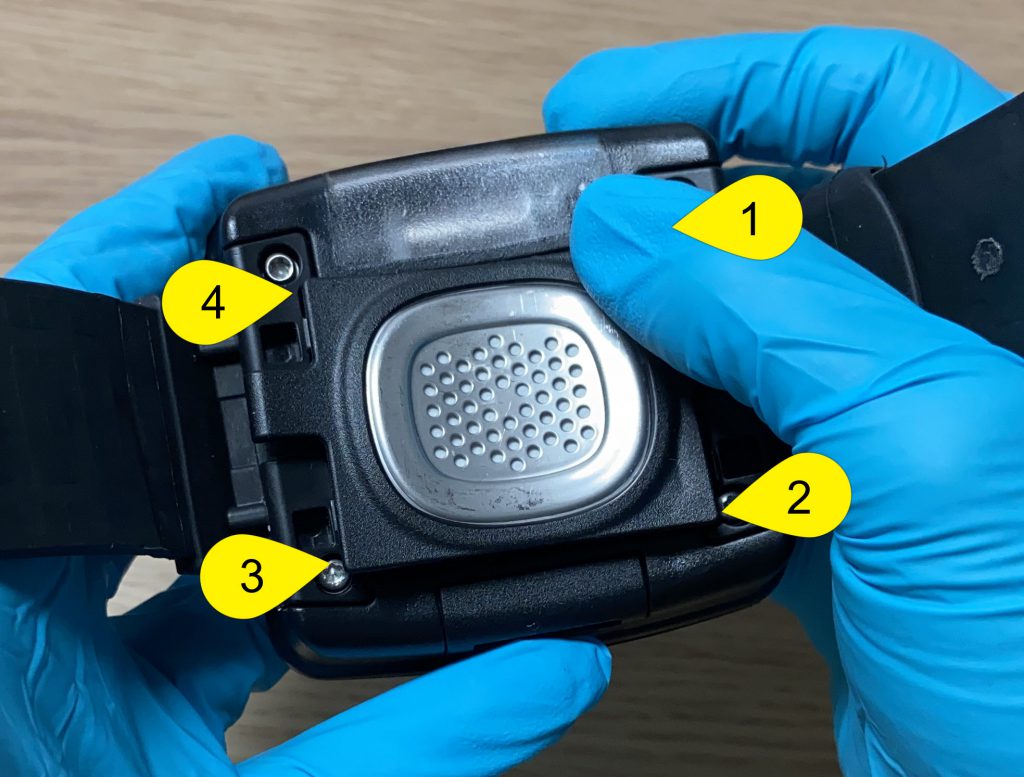

- Install the faceplate.
- Lay the faceplate over the back of the bracelet.
- Starting in the upper right corner, press down firmly until you hear a click.
- Moving clockwise on the faceplate, press down firmly in each of the remaining corners. Ensure you hear a click in each corner.
- It may be necessary to remove the faceplate and reinstall if you do not hear a click in each corner of the faceplate.
Be aware, moisture may enter under the faceplate if these instructions are not followed.
![]() |
![]() |
| Clean the battery contacts | Install battery |
![]() |
![]() |
| SCRAM CAM Bracelet Faceplate | SCRAM House Arrest Bracelet Faceplate |
Note: If you will be installing the bracelet in a remote location with limited internet access or no internet access available, you can assign the equipment before meeting with the client. In that case, it is important you do not close the bracelet straps until after installing the bracelet on the client’s ankle. Once the bracelet is installed and secure on the client’s leg, use the magnet provided by SCRAM Systems to activate the bracelet. This will start the bracelet initialization, which establishes the IR baseline, and record the first test for alcohol monitoring if applicable for the client.
Install the Bracelet on the Client
SCRAM Systems recommends clients who will be monitored for both alcohol and curfew violation be given a breath alcohol test to ensure they are alcohol-free before installing the SCRAM CAM bracelet on their ankle.
Client’s utilizing the SCRAM House Arrest bracelet for curfew monitoring only, do not require an alcohol breath test.
- Install the bracelet on the client’s leg with the serial numbers facing up toward the knee, and low on the client’s leg. About a finger width above the right or left ankle bone.
- Feed the long strap into the buckle until the bracelet is snug against the skin.
- SCRAM CAM Bracelet (alcohol and curfew monitoring)
- The bracelet should be able to move side to side on the leg without losing contact with the skin.
- The bracelet should not be able to be rotated across the shin bone or the back of the leg without exerting a lot of effort.
- Be aware, a poorly fitted bracelet could have some impact on the bracelet’s ability to take accurate readings and may result in unneeded time taken to refit the bracelet.
- SCRAM House Arrest Bracelet (curfew monitoring only)
- The bracelet should fit snug on the client’s ankle but does not have to be in constant contact with the skin.
- The bracelet should not be able to be rotated across the shin bone or the back of the leg without exerting some effort.
- Be aware, a poorly fitted bracelet could have some impact on the bracelet’s ability to take accurate readings and may result in unneeded time taken to refit the bracelet.
- SCRAM CAM Bracelet (alcohol and curfew monitoring)
- Tighten both the screws on the buckle top to secure the long strap in place.
- To properly align the bracelet strap, ensure the tooth alignment tab is positioned between two teeth when the buckle top is tightened.
- Be aware, improper alignment may result in unneeded time taken to refit the bracelet.
- Secure the loose end of the strap with the buckle loop.
- Install the tamper clips on the buckle.
- Insert both tamper clip parts into the buckle slots and squeeze the two parts together. You should hear a click.
- Take a moment to ensure the clips are secure by trying to pull them apart.
Note: Ensure the tamper clip parts are free of cracks or fractures. Never reuse tamper clips.
Assign Bracelet and Base Station
Assign the bracelet and base station to the client:
- Plug the base station in to a power source.

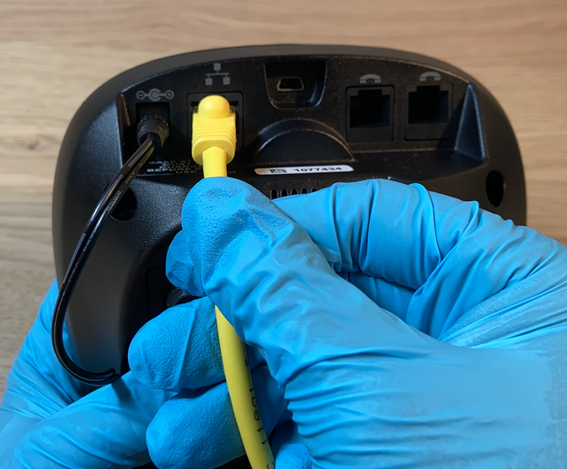

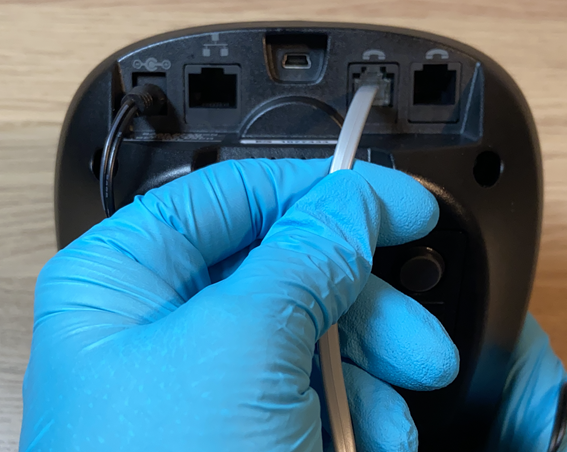

- Connect the base station to either an Ethernet or telephone landline outlet. The base station will contact and communicate with SCRAMNET via the connected communication method, and the LCD screen will display the communications tasks it is performing to connect to SCRAMNET.
Helpful Tip: When connecting to a telephone landline, a DSL filter may need to be used, to ensure the base station is able to communicate with SCRAMNET.

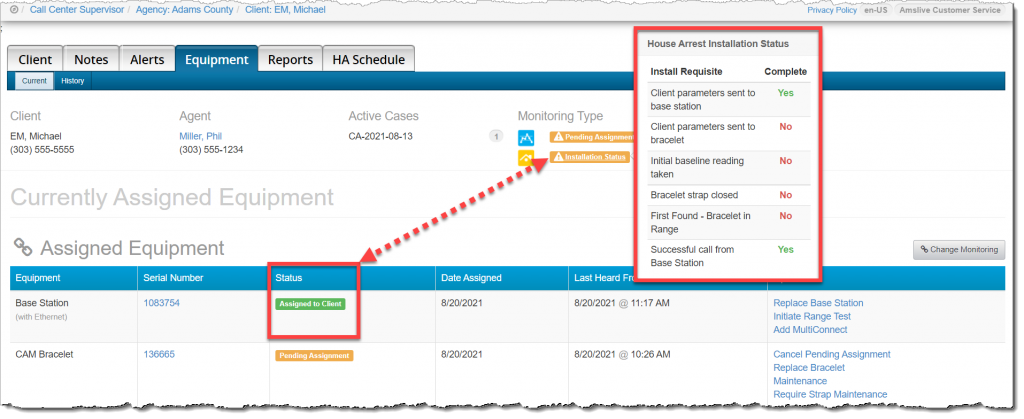

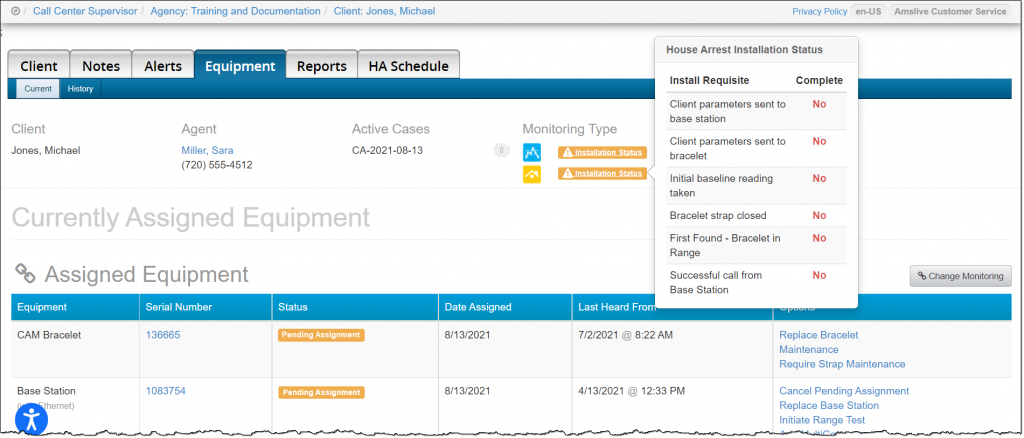

- Once the LCD screen displays Monitoring, if available, navigate to the client’s Equipment page in SCRAMNET and refresh the page. The base station’s status should display as Assigned to Client and two of the install requisites are complete.

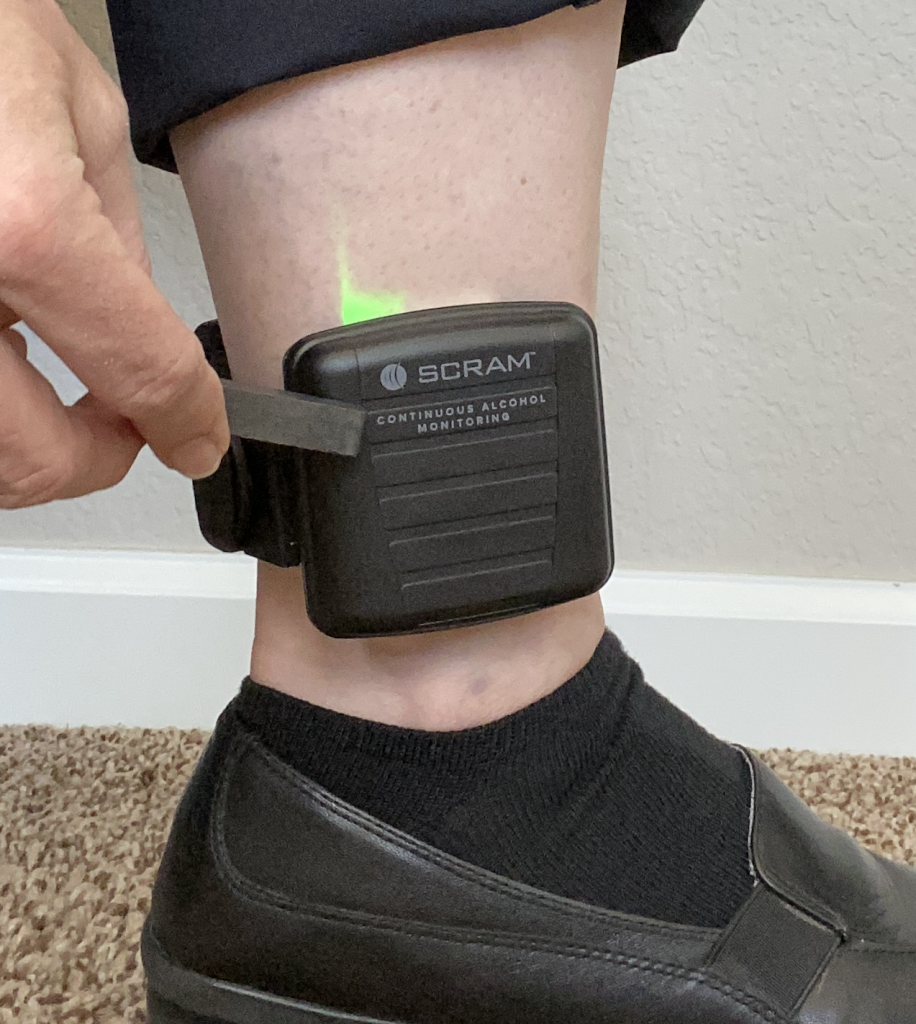

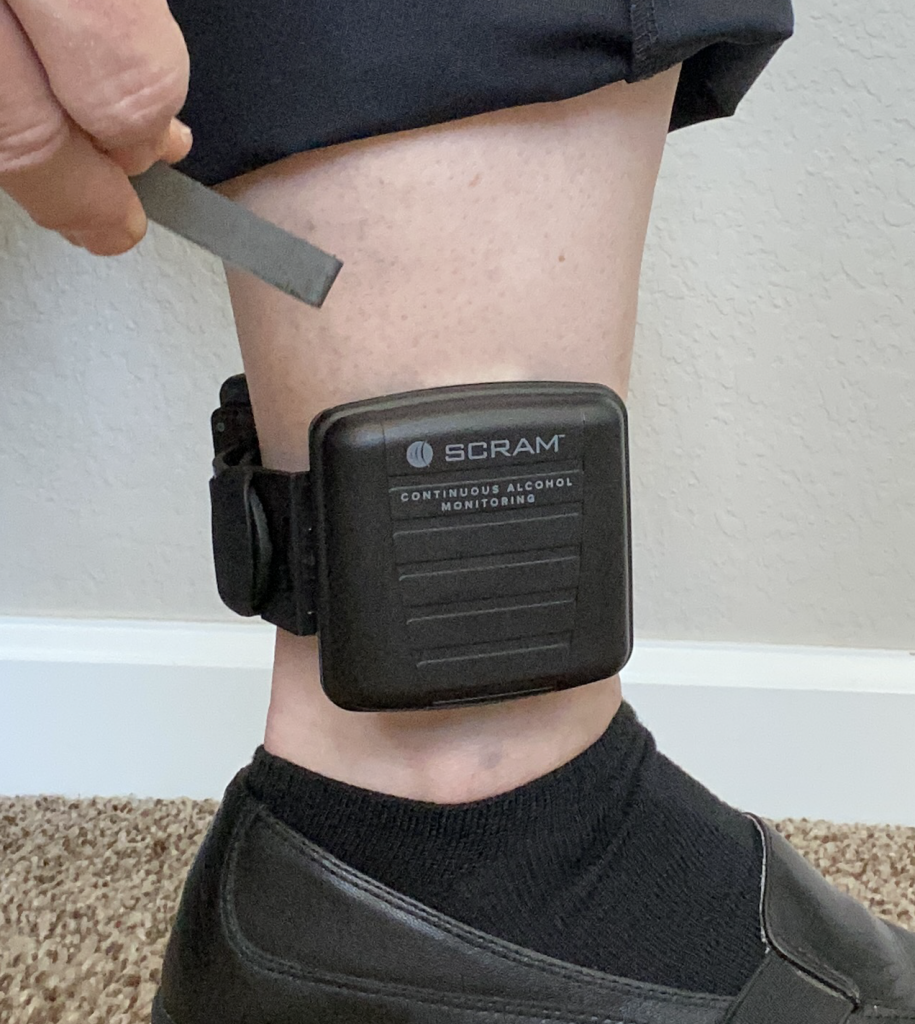

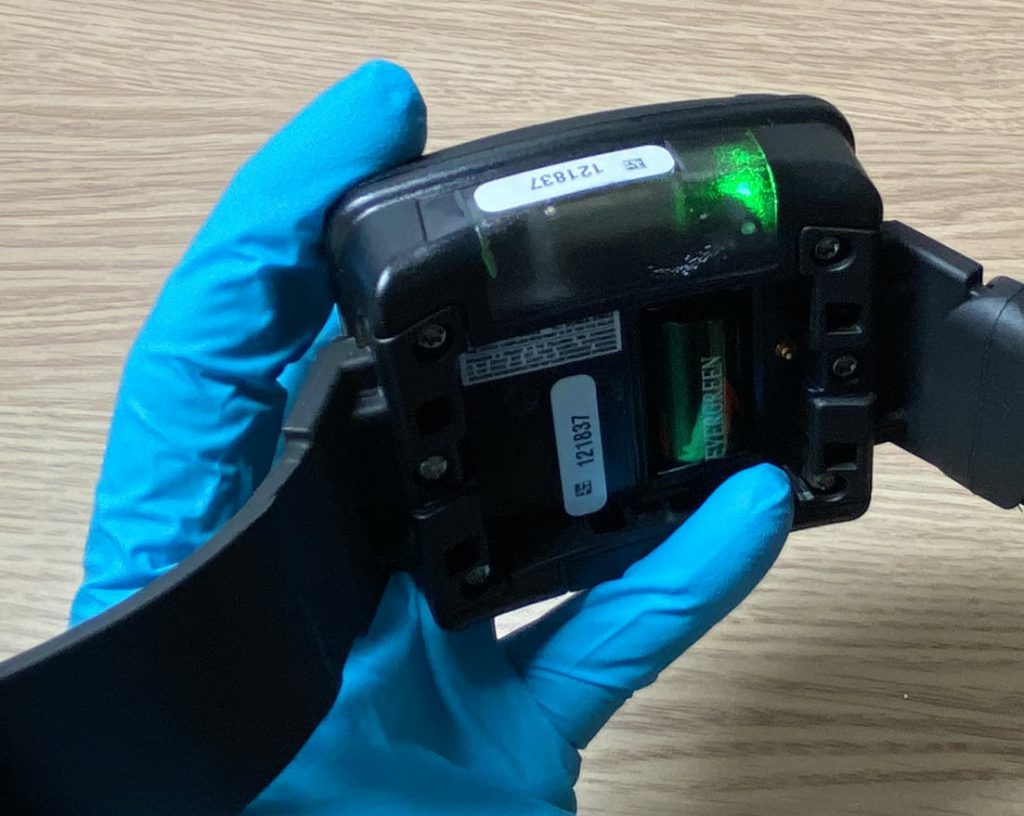

- Place the SCRAM approved magnet on the top left corner of the bracelet until the green light on the bracelet turns on. Once the green light is on, remove the magnet.
![]() |
![]() |
- After a moment, the base station’s LCD screen will update to “Reading Bracelet”.
- The base station will contact and communicate with SCRAMNET via the connected communication method, and the LCD screen will display the communication tasks it is performing to connect to SCRAMNET.

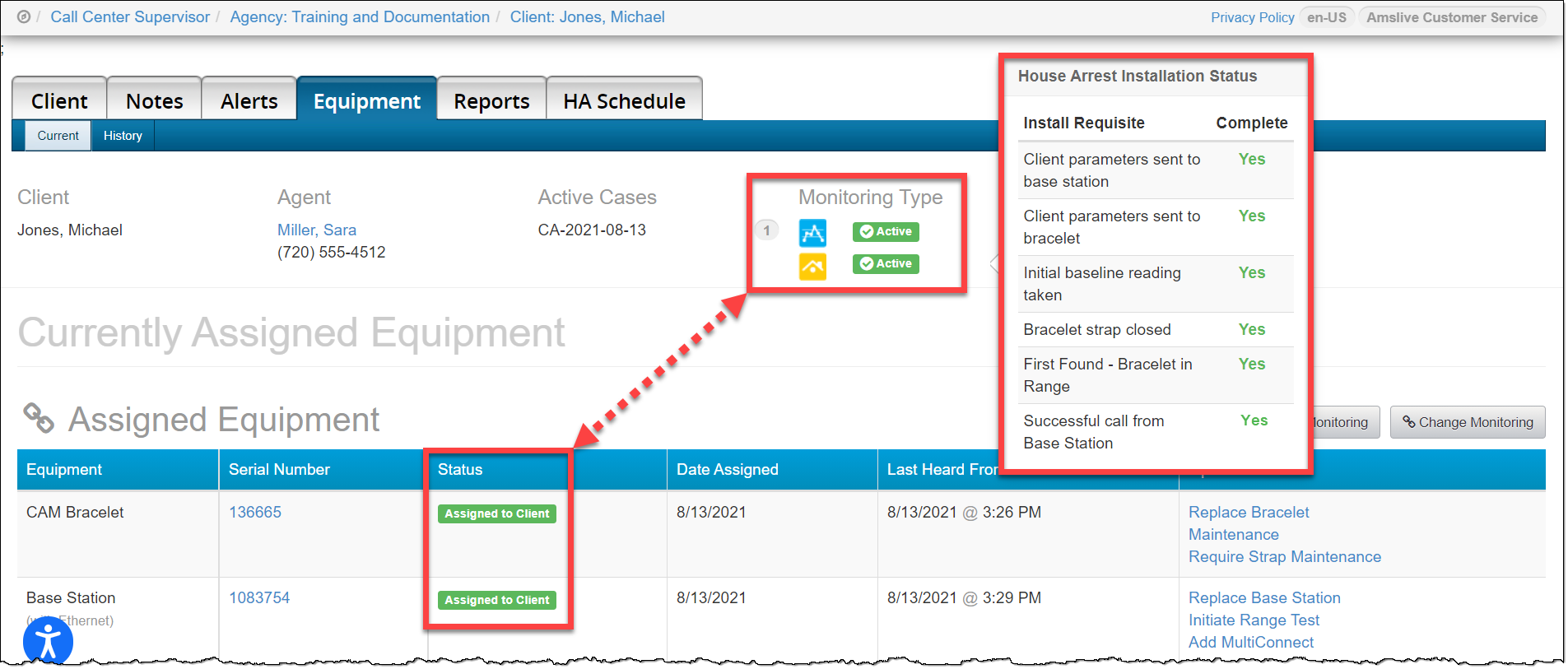

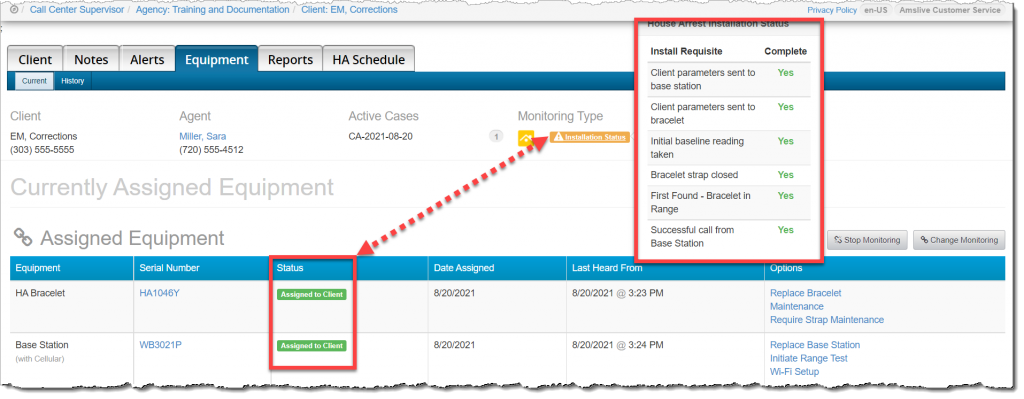

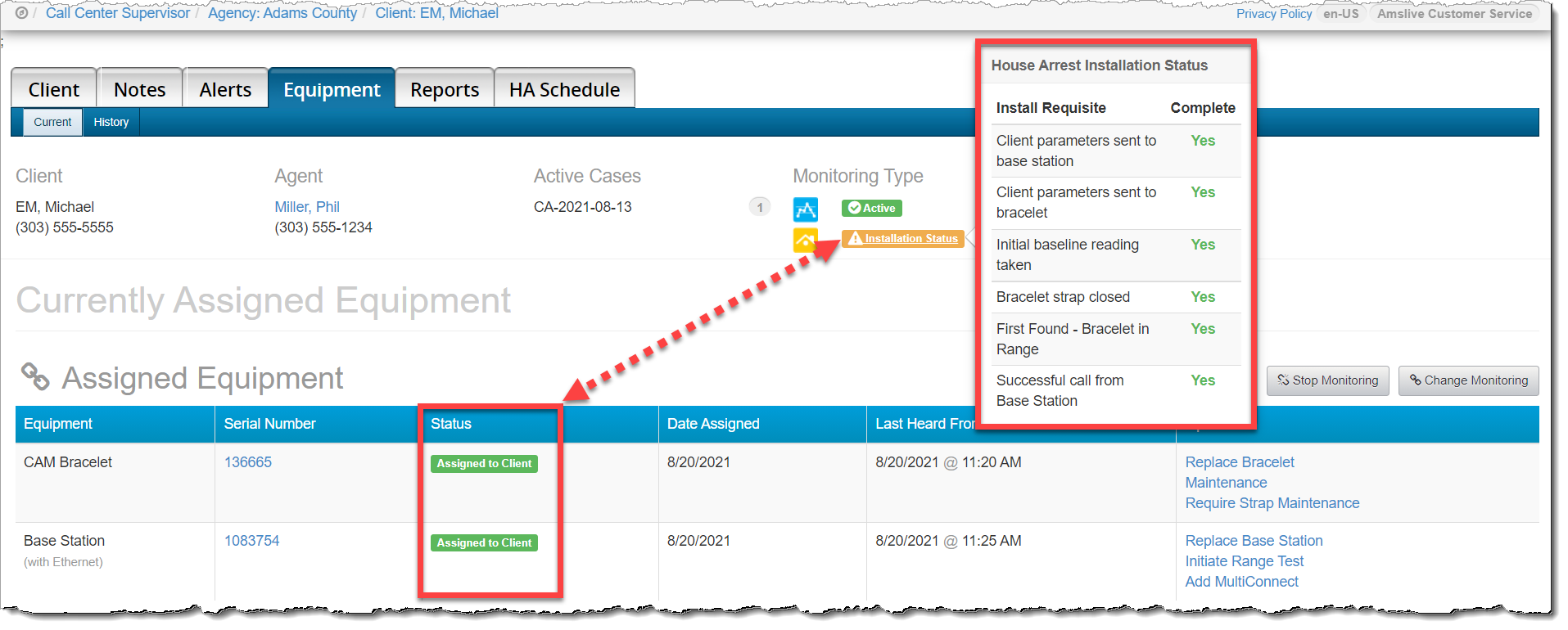

- Once the LCD screen displays Monitoring, if available, navigate to the client’s Equipment page in SCRAMNET and refresh the page. The bracelet’s status should display as Assigned to Client, and the remaining install requisites should display as complete for active SCRAM House Arrest monitoring.

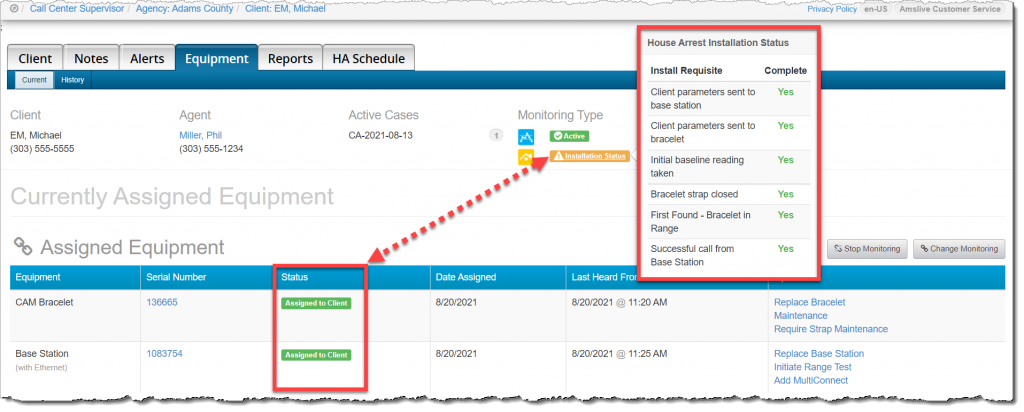

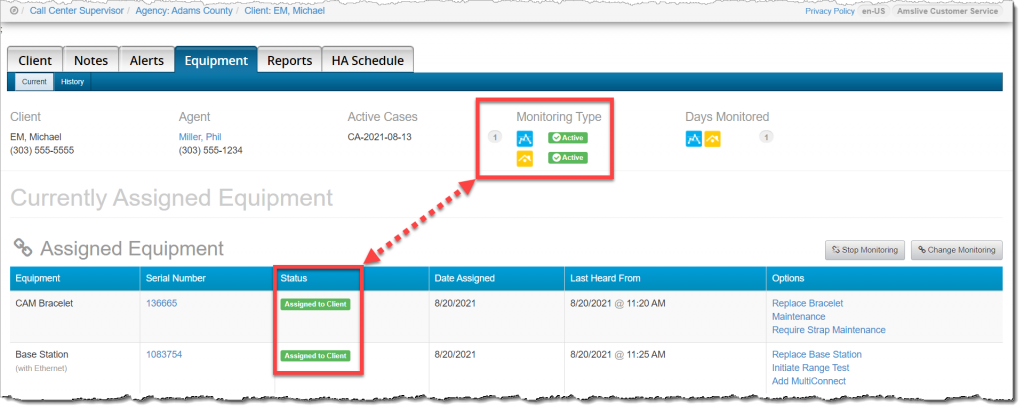

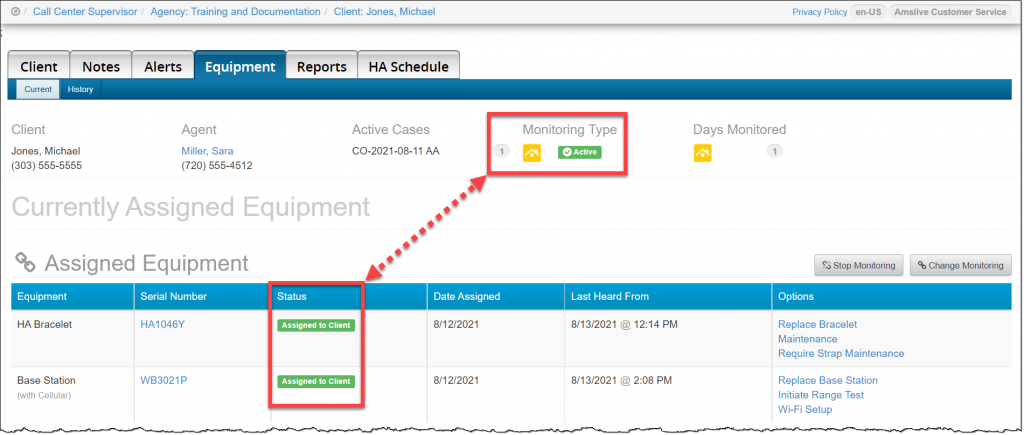

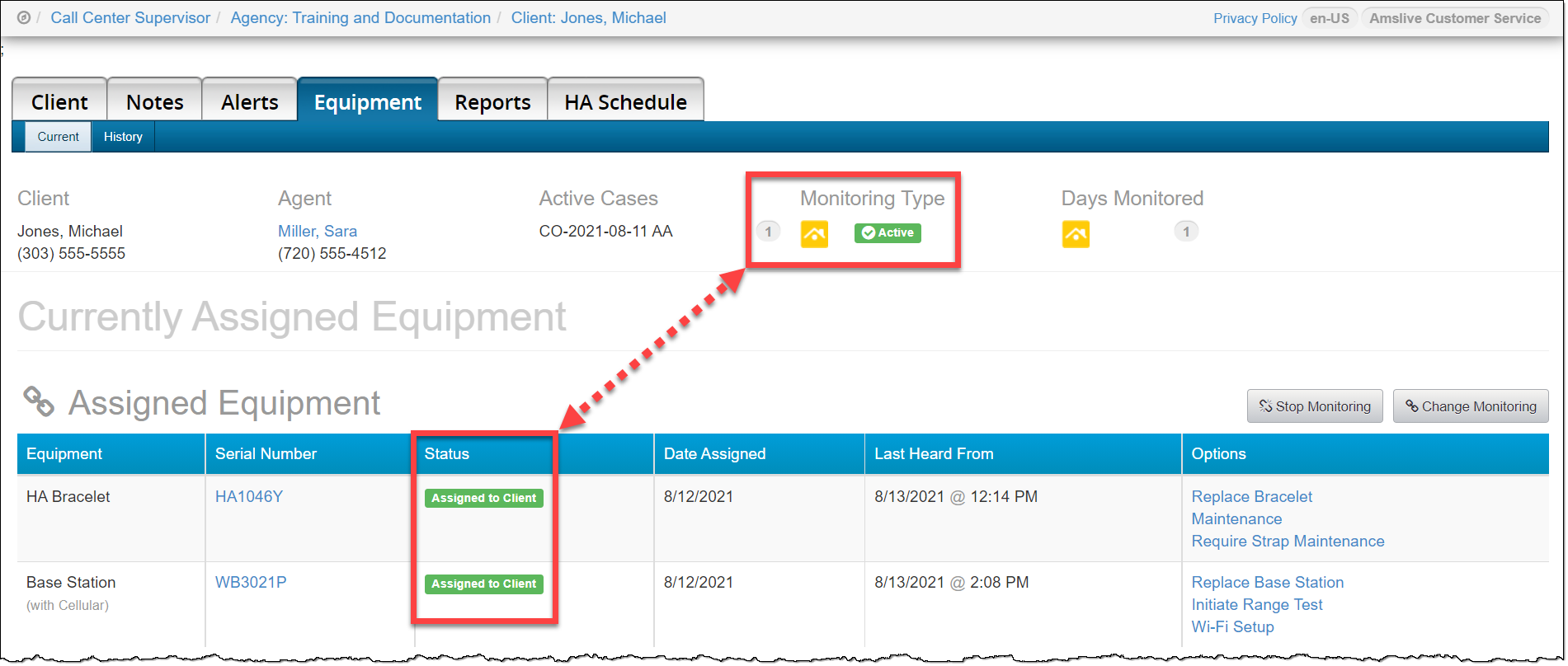

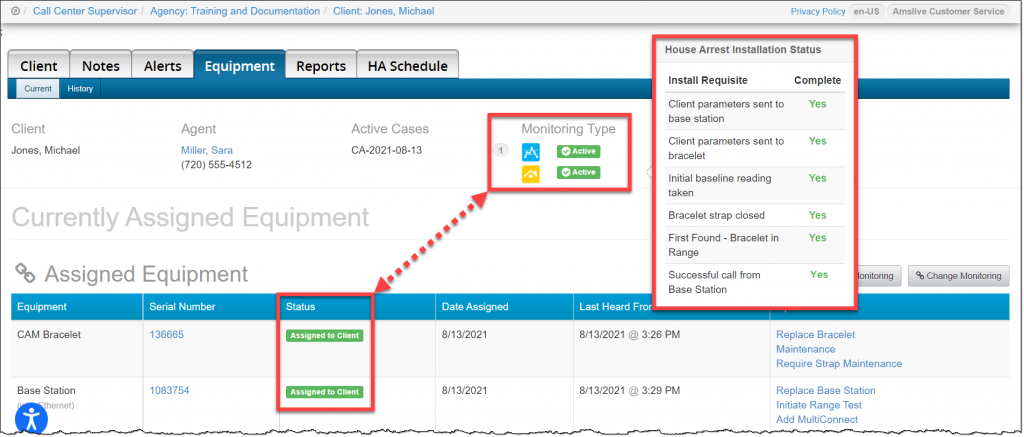

After one minute, the Monitoring Type will update to Active in SCRAMNET.
Go to the Final Checks section.
Assign Wireless Base Station
To assign the bracelet and wireless base station to the client:

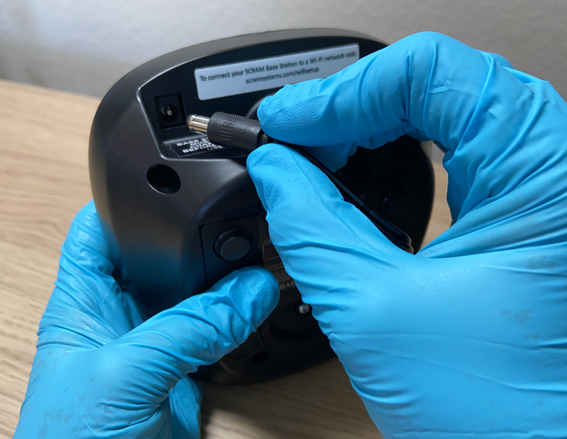

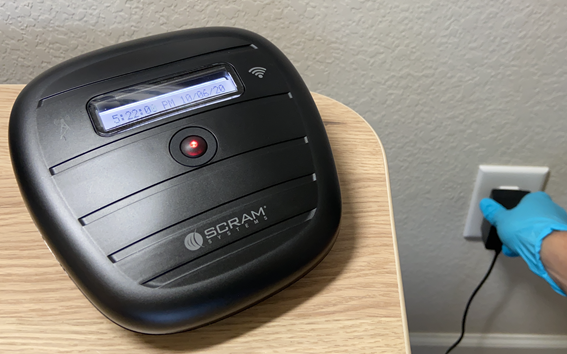

- Plug the base station into a power source.
-
- When connecting over the Cellular network, the LCD screen on the base station will display:
- “Storage Mode – Battery Charging – None” or “Fully Charged – None”
- “[Current Time and Date]” and “Monitoring – 3G” or “Monitoring – 4G”
- When connecting over Wi-Fi the LCD screen on the base station will display:
- “Storage Mode – Battery Charging- Noen” or “Fully Charged – None”
- “[Current Time and Date]” and “Monitoring – Wi-Fi”
- When connecting over the Cellular network, the LCD screen on the base station will display:

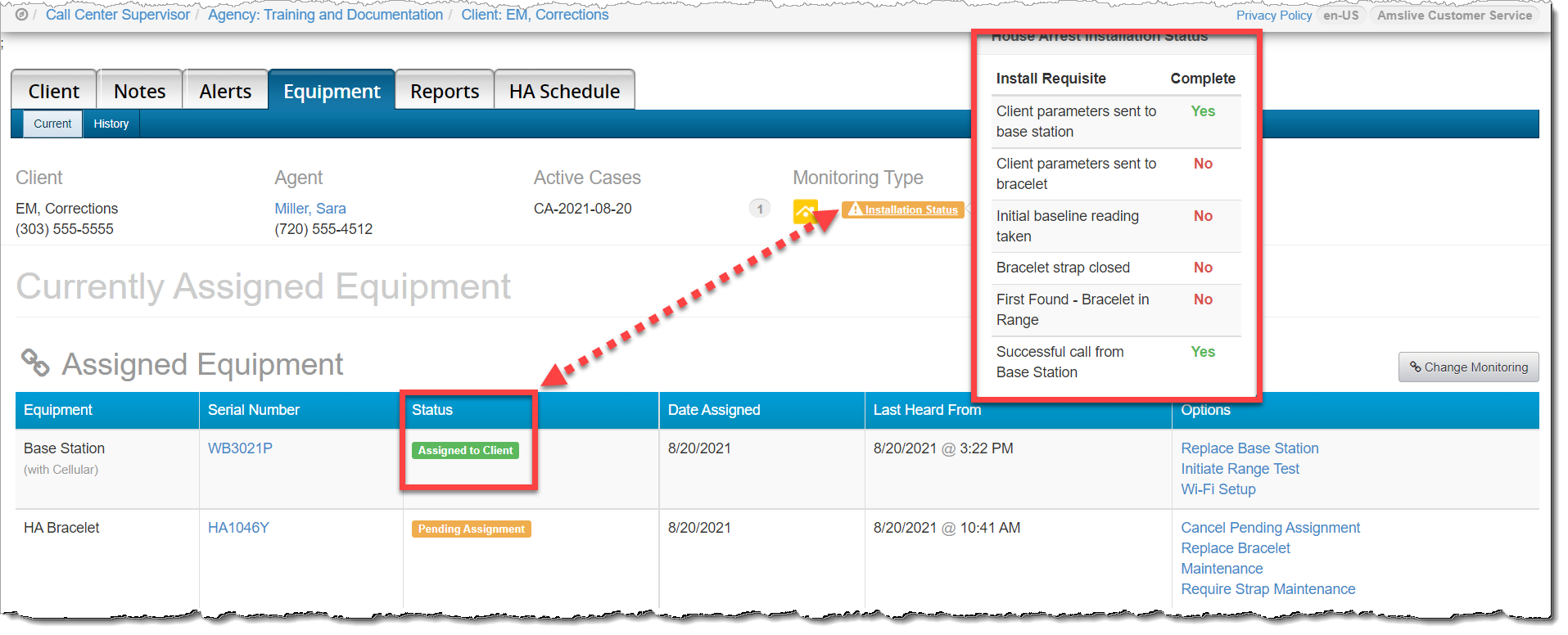

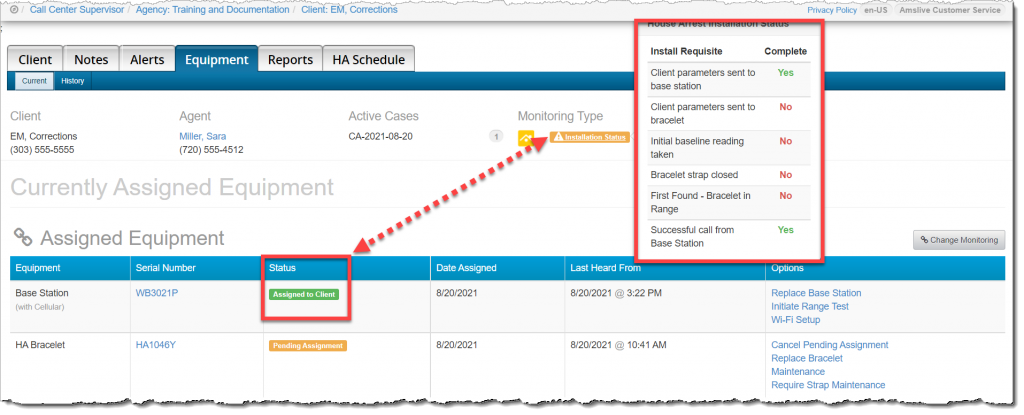

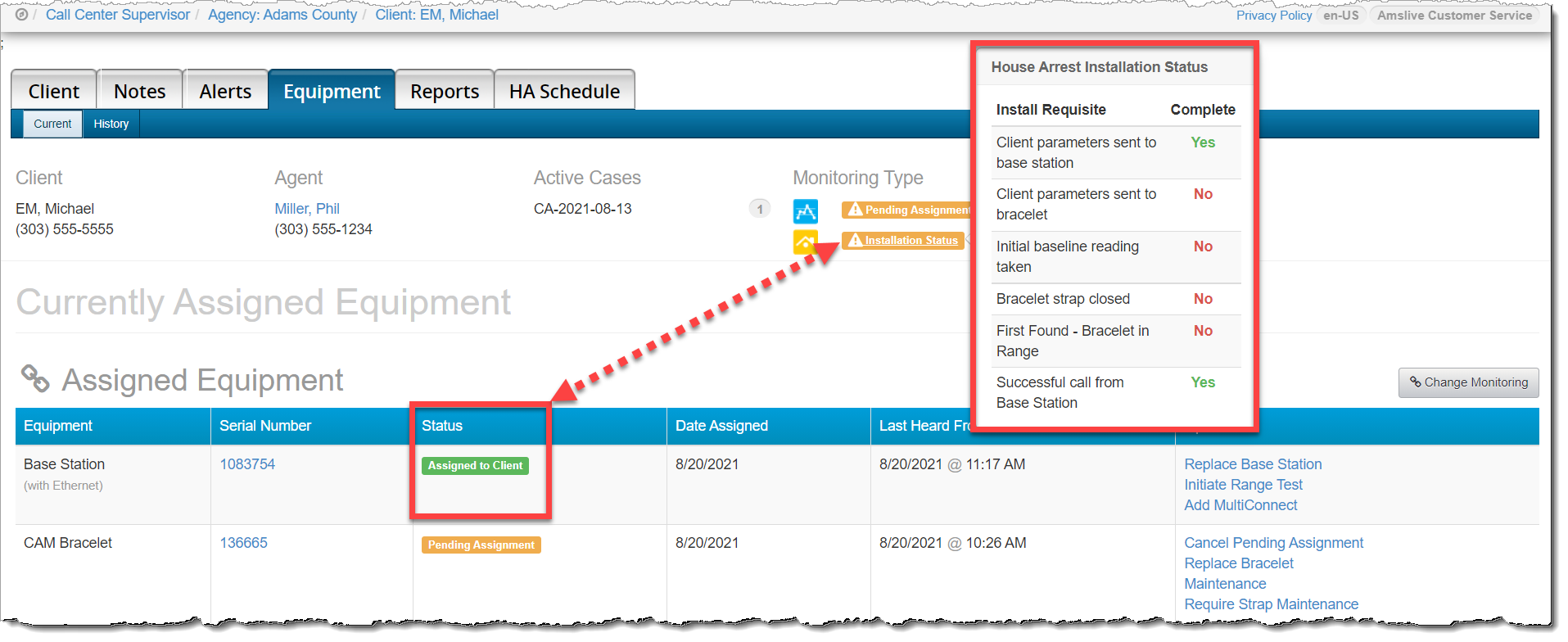

- Once the status on the LCD screen displays the current date and time and “Monitoring”, if available, refresh the Equipment page in SCRAMNET. The wireless base station’s equipment status should now display as Assigned to Client and two of the install requisites complete.
- Place the SCRAM approved magnet on the top left corner of the bracelet until the green light on the bracelet turns on. Once the green light is on, remove the magnet.
![]() |
![]() |
- After a moment, the base station’s LCD screen will update to “Reading Bracelet”.
- The base station will contact and communicate with SCRAMNET.
- Once the LCD screen displays Monitoring, if available, navigate to the client’s Equipment page in SCRAMNET and refresh the page. The bracelet’s status should display as Assigned to Client, and the remaining install requisites should display as complete for active SCRAM House Arrest monitoring.
Note: You may have to refresh the client’s Equipment page several times as the install requisites are communicated and completed.

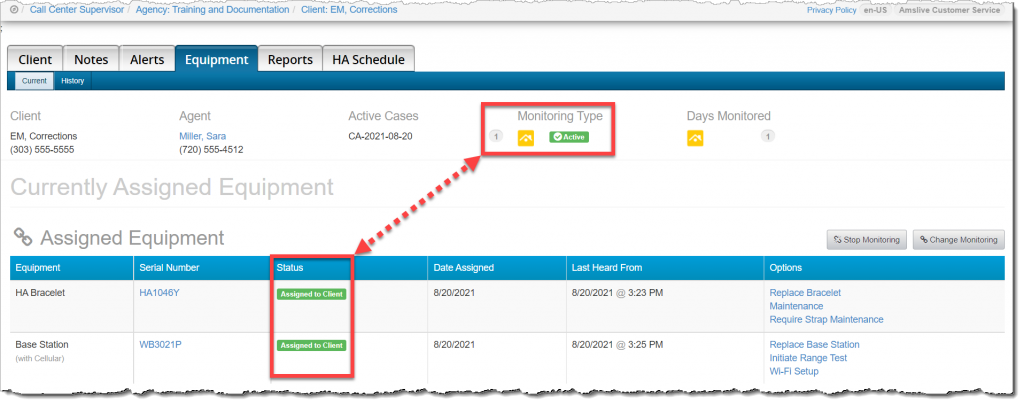

After one minute, the Monitoring Type will update to Active in SCRAMNET.
Troubleshooting the Bracelet’s Assignment and Install Requisites

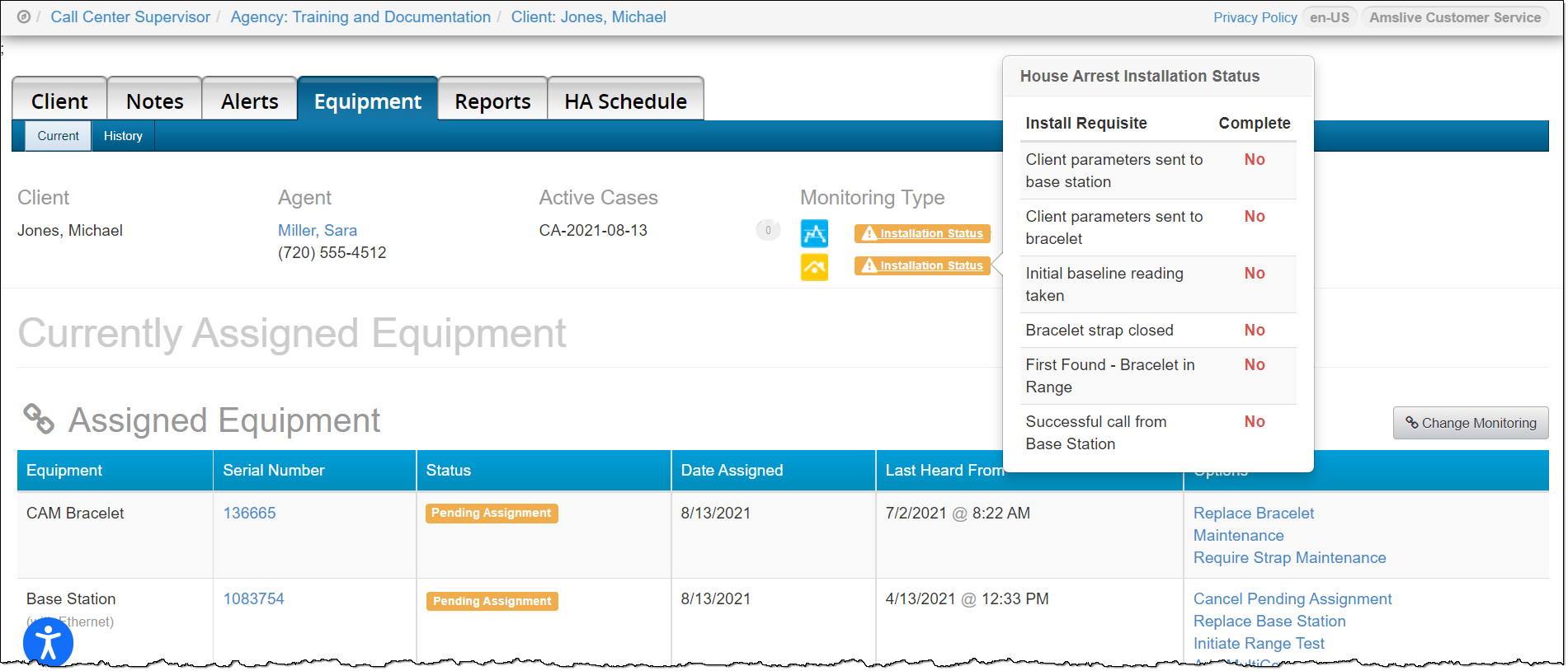

If the bracelet does not assign, or if the bracelet specific install requisites are not complete after 15 minutes in SCRAMNET:
- Ensure your computer has an active connection to SCRAMNET. When using a Wi-Fi or a hot spot connection, you may have to reconnect and refresh SCRAMNET to ensure you have the latest updates.
- Verify the bracelet’s serial number in SCRAMNET matches the bracelet’s serial number on the client’s leg.
- Ensure the bracelet is in “range” of the base station (bracelet and base station in the same room).
- When waking up the bracelet with a magnet, ensure the green light on the bracelet turns on.
- Remove the bracelet from the client’s leg and re-install. When installing, verify the straps and buckle are aligned properly.
If all troubleshooting steps fail, contact Customer Service for assistance.
Troubleshooting Wireless Base Station Assignment Issues (WBS Troubleshooting)
If the base station does not assign in 15 minutes and the LCD screen still displays “None”, unplug the base station from power. Place the base station in a new location where better cellular connection may be available and connect to power.
If after 15 minutes the wireless base station still does not assign:

- Select the Cancel Pending Assignment hyperlink under the Options

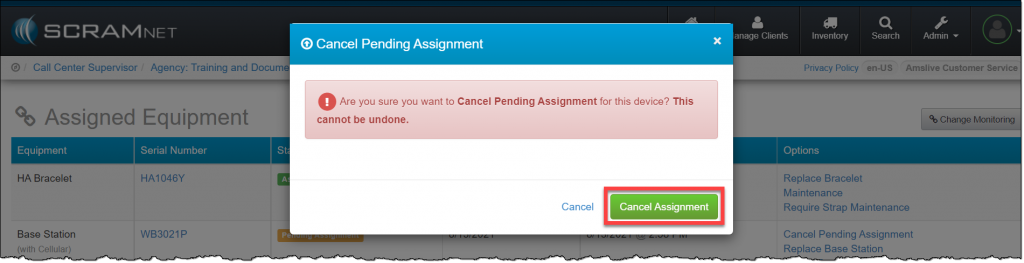

- Acknowledge the Cancel Pending Assignment warning pop-up.
- On the client’s Equipment page, click the Add Base Station hyperlink under the Options column and complete the Assign Equipment page.
- Once the wireless base station is in a Pending Assignment status, connect to power.
If all troubleshooting steps fail, contact Customer Service for assistance.
Final Checks

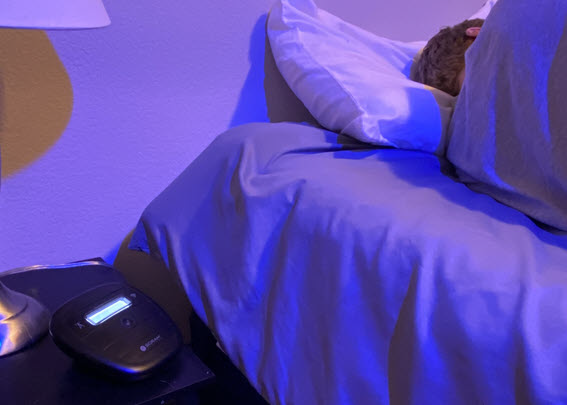

For best results, instruct the client to place the base station or wireless base station at least three feet off the floor, away from any other electronics or reflective surfaces that may cause interference. If possible, place the base station in a central location in the home.
Take a moment to verify:
- The tamper clips have been securely installed on the bracelet.
- The status of the client’s equipment is showing Assigned to Client in SCRAMNET.
- You have provided the client with any additional instructions.
- You have reviewed the Participant agreement with the client and have a signed copy for your records.
Important Note: The client is not active for House Arrest monitoring until all the equipment associated to the client and all six installation requisites are complete. Once complete, the Monitoring Type displays as Active.
|
